Bunker Hill Begins Construction of Processing Plant and Starts Resource Expansion Drill Program

896
Image Bunker Hill Mining Corp.
Image Bunker Hill Mining Corp.

TORONTO – Mining Press Release – Bunker Hill Mining Corp. (“Bunker Hill” or the “Company”) (TSXV: BNKR, OTCQB: BHLL) is pleased to provide an update on its Bunker Hill Mine located in Kellogg, Idaho. A call with the management is scheduled to be held on Tuesday, May 21st, 2024 at 8 a.m. (Pacific time) to provide an update and answer questions. Additional details regarding the call are available here:

https://events.6ix.com/preview/our-strategic-expansion-drilling-program-and-infrastructure-milestones

“The start of our processing plant construction represents a vital and exciting milestone in our journey to restart the Bunker Hill Mine.” said Sam Ash, CEO, “We are on track for the planned start of both mining and mill commissioning by the end of this year, with the goal of ramping up to full production through Q1 2025”.

CONSTRUCTION STARTED OF THE CONCRETE FOUNDATIONS FOR THE PROCESSING PLANT

Bunker Hill Mining Corp.

On April 30, 2024, the Company received its critical Pre-Permit to Construct from the Idaho Department of Environmental Quality (IDEQ), allowing the Company to start construction of its processing, and associated tailings management and mining facilities. This essential permission was granted following a detailed review of the Company’s Air Emissions Model and all its associated controls.

The Company is on track to start technical commissioning of the plant during Q4 2024. This will be concurrent with the planned start of mining and the building up of stockpiles; with the ramp up to full production through the first quarter of 2025.

OPTIMIZED TAILINGS FILTRATION PLANT

After completing a detailed review of the Bunker Hill restart plant, the Company elected to optimize the Tailings Filtration Plant design to ensure both the highest possible standards of long-term environmental management and the ability to ramp up operations from 1800-2500 tpd over time.

This final design favored the more effective, but more expensive, pressure filtration system over the disk filter method considered in the Company’s preliminary feasibility study for the Bunker Hill Mine dated September 30, 2022 and reported in a news release dated October 18, 2022 that can be found here. The engineering for the new Filtration Plant has passed the 60% engineering milestone; with construction of the foundations intended to start in June 2024 following the setting of the deep piers.

Bunker Hill Mining Corp.

The costs associated with the optimization of the Tails Filtration solution coupled with other key activities to de-risk the original design of the processing plant – specifically greater investment in deep pier stability, have been incorporated into a revised project budget and mining schedule. This optimization currently projects a marginal increase in the original ‘total cost-to-complete’ budget approved in Q1 2023, the start of mining in Q4 2024 with a ramp up to full production through Q1 2025. These adjustments have been incorporated into the on-going re-financing process, as detailed below.

RE-FINANCING UPDATE

The Company has been financing the project since H1 2023 using the US$67M financing package provided by Sprott Streaming. To improve projected free cashflow/share once the mine is in production, the Company has been conducting a re-financing process concurrent with advancing and thereby de-risking the total project plan. This aims to both lower the cost of project capital as well as increase the total quantum of capital available for the updated and de-risked project plan.

After three months, the company is pleased to report that this process has identified multiple suitable options, and a preferred solution with signed term sheet has been chosen. As a result, we have now moved into the execution phase and are on track to conclude this within the next 60 days. Additional details and progress updates will be provided in due course.

EXPLORATION DRILLING COMMENCEMENT

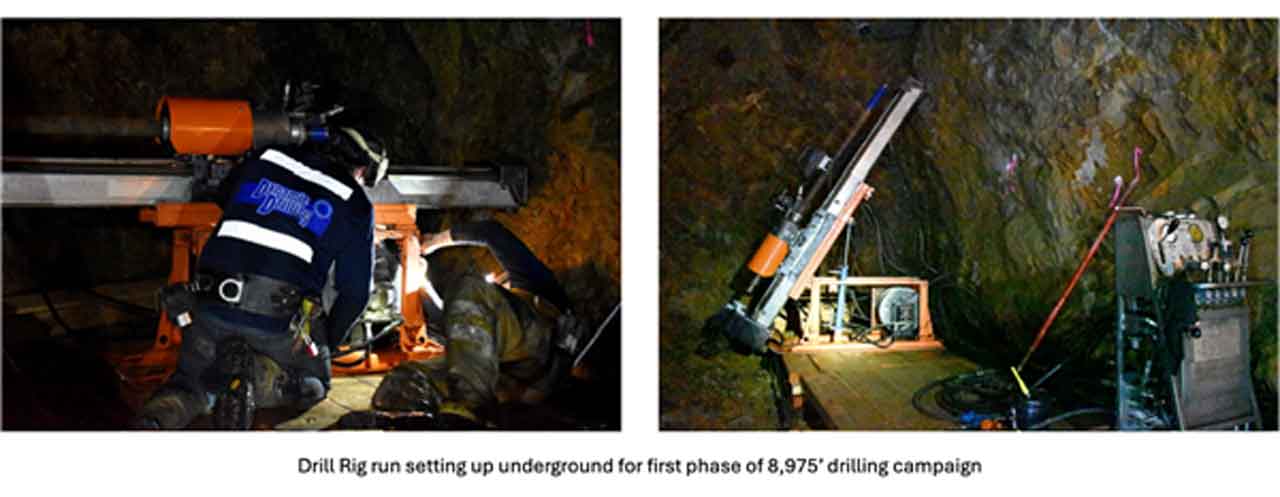

On May 10th, the Company initiated a resource expansion and exploration drilling program in support of the staged restart plan. This limited and precise program is fully funded within the existing restart budget. Over the coming months, 8,975 feet of core will be drilled from underground to further define and expand the existing resource. The initial drill targets are in close proximity to where the initial mining phase will take place.

Bunker Hill Mining Corp.

Bunker Hill Mining Corp.
This is the first phase of a staged, deliberate, multi-year exploration and resource expansion drill program, to be funded from operating cashflow when the mine is in production.

Qualified Person

Mr. Scott Wilson, is an independent “qualified person” as defined by NI 43-101 and is acting as the qualified person for the Company. He has reviewed, verified and approved the technical information summarized in this news release, including the sampling, preparation, security and analytical procedures underlying such information, and is not aware of any significant risks and uncertainties that could be expected to affect the reliability or confidence in the information discussed herein.”

About Bunker Hill Mining Corp.

Bunker Hill Mining intends to sustainably restart and develop the Bunker Hill Mine as the first step in consolidating and then optimizing several mining assets into a high-value portfolio of operations delivering critical metals into the market, initially focused on North America. Information about the Company is available on its website, www.bunkerhillmining.com, or the SEDAR+ and EDGAR databases.

On behalf of Bunker Hill Mining Corp.

Sam Ash
President and Chief Executive Officer

Bunker Hill Mining Contact:

Brenda Dayton
Vice President, Investor Relations
T: 604.417.7952
E: brenda.dayton@bunkerhillmining.com
